Skip to main content

Cost Insights

Cost Insights shows estimated costs and compute time for your dbt projects and models directly in the dbt platform, so you can measure and share the impact of optimizations like dbt State and state-aware orchestration.

State-aware orchestration is now dbt State

dbt State works with all engines and environments: dbt Core, dbt platform, and Fusion

If you're using state-aware orchestration prior to June 1, 2026, you can continue using it. Your dbt State trial will be extended until the billing period begins on September 1, 2026. If your trial wasn't extended, contact your account team. To get started, refer to Migrate from state-aware orchestration.

dbt State and state-aware orchestration make your dbt workflows more efficient by reusing models and tests instead of running full rebuilds. When either is enabled, Cost Insights helps you demonstrate the resulting cost reductions and efficiency gains. These cost and cost reduction estimates are based on a retroactive analysis of runs after you enable Fusion and dbt State or state-aware orchestration. They reflect actual historical usage, not forecasts of future costs or cost reductions.

With Cost Insights, you can see:

  • How much your dbt models cost to run: See the compute cost and times for each model and job in your warehouse's native units.
  • The cost reductions from using dbt State or state-aware orchestration: Understand the cost reduction when dbt State or state-aware orchestration reuses unchanged models.
  • Cost trends over time: Track your warehouse spend and optimization impact across your dbt projects.
  • Asset type filtering: On Cost Insights charts (Cost, Usage, Query run time, Builds), use the Assets dropdown menu to filter data by Models, Tests, or All. Each tab keeps its own selection.
  • Per-job cost breakdown: In the Cost Insights table view, use the All and Jobs buttons to switch between an aggregated view and a per-job cost breakdown.

The Cost Insights section is available in different dbt platform areas and lets you view your cost data and the impact of dbt State and state-aware orchestration optimizations across various dimensions:

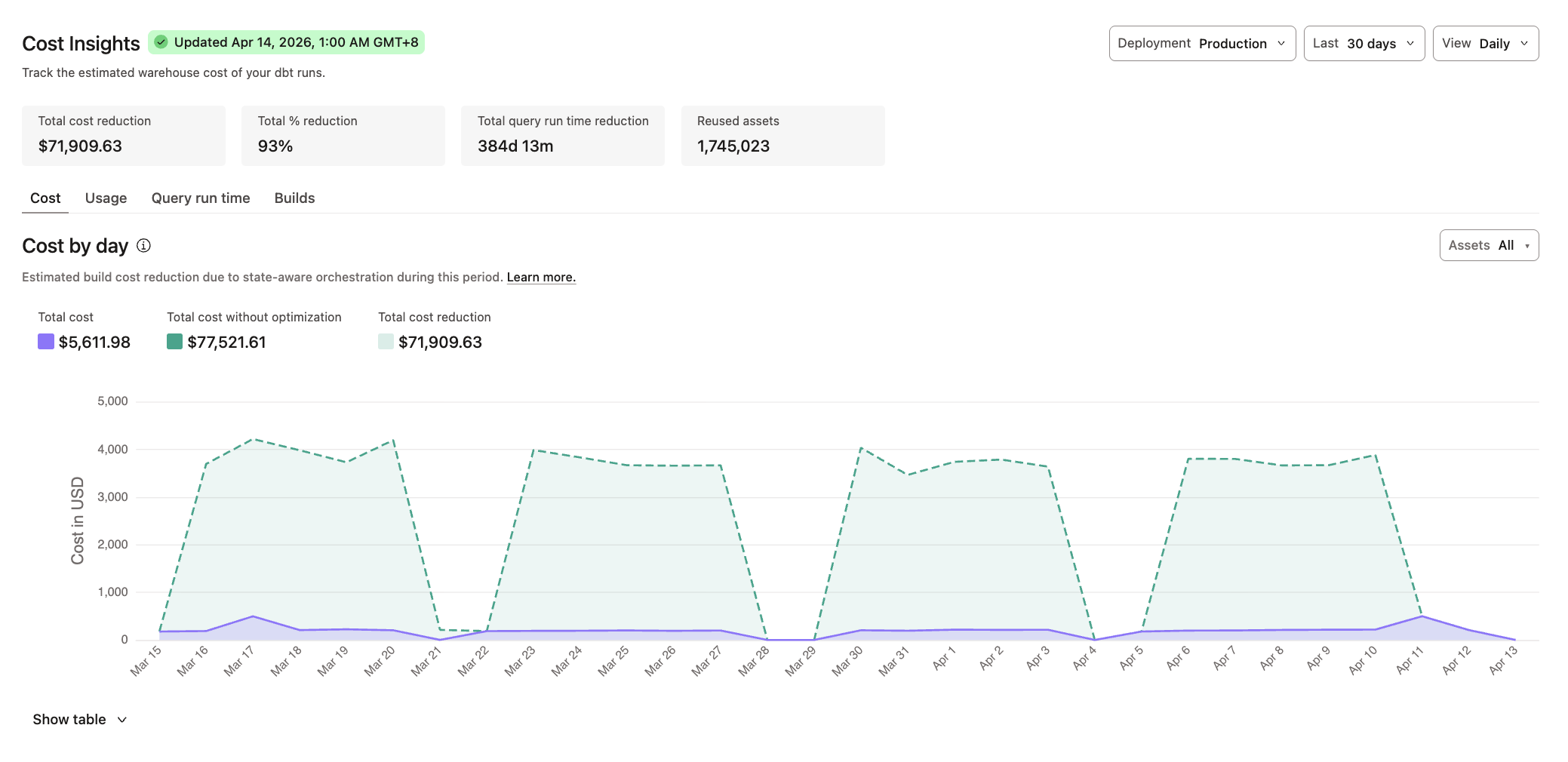

Cost Insights in the project dashboardCost Insights in the project dashboard
Cost Insights in CatalogCost Insights in Catalog

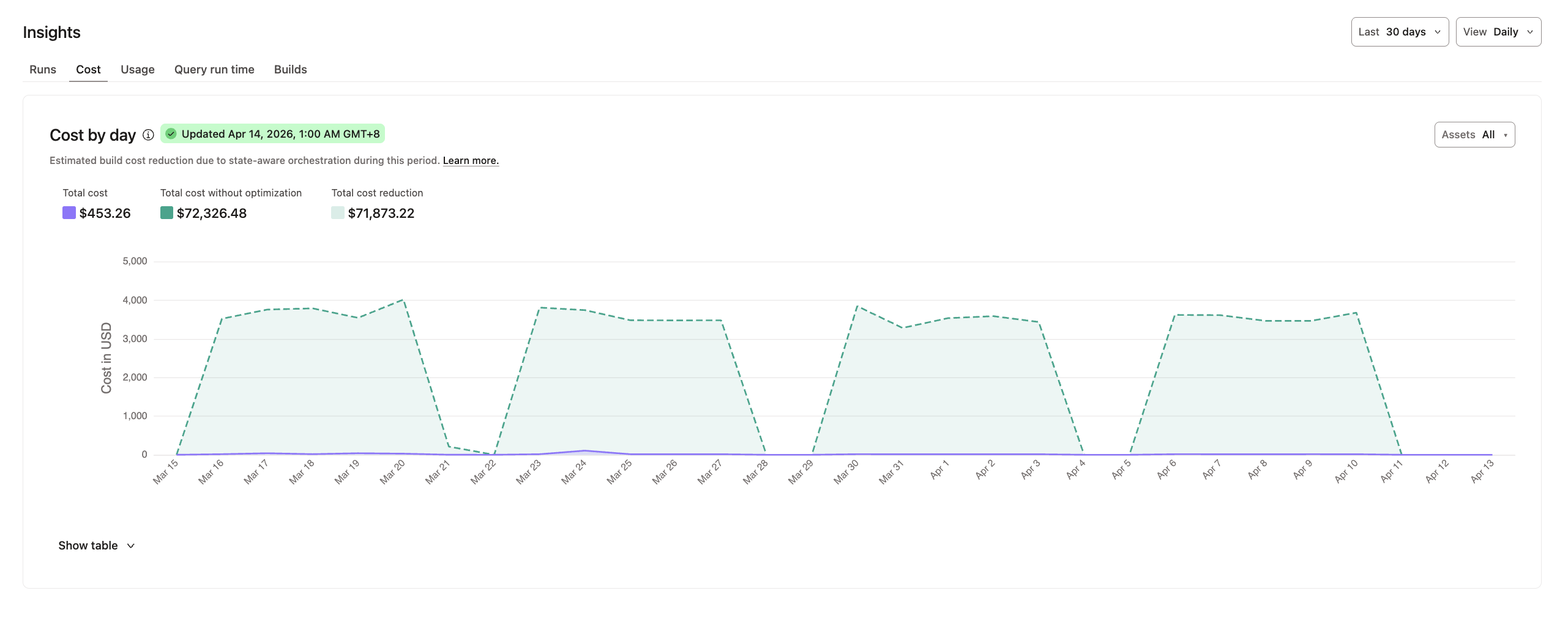

Cost Insights in job detailsCost Insights in job details

Prerequisities

To view cost data, ensure you have:

For setup instructions, see Set up Cost Insights.

Understanding cost and reduction estimates

note

Cost estimates are intended for visibility and optimization, not billing reconciliation.

dbt calculates the cost of running your dbt models using your data warehouse's usage metadata and billing context. dbt computes costs daily using up to the last seven days of available data.

Warehouse-specific logic

The following sections explain how costs are calculated for each supported warehouse. Expand each section to view the details.

 Snowflake

dbt computes Snowflake query costs using Snowflake's query attribution data and your credit price (price_per_credit). dbt pulls the price_per_credit value directly from Snowflake when available; otherwise, dbt uses the configured or default value in the dbt platform. For more information about configuring or viewing these values, see Configure Cost Insights settings.

Formula:

credits_per_query * price_per_credit

Where:

Snowflake attribution limitation

Snowflake doesn't attribute cost to queries that run in roughly 100 milliseconds or less. As a result, Cost Insights totals may be lower than the compute spend shown in your Snowflake billing dashboards. For more information, see the Snowflake documentation.

 BigQuery

BigQuery does not expose per-query cost directly in system tables. Instead, dbt estimates cost by combining query usage with a pricing input (either from your configuration or the default rate).

  • On-demand pricing

    The cost is determined by how much data each query processes. The usage shows the amount of that data billed for the query.

    Formula:

    data_processed_per_query * price_per_tib

    Where:

    • data_processed_per_query - Total data billed for the query (normalized to TiB). dbt sources this value from information_schema.jobs.total_bytes_billed. For more information, see the BigQuery documentation.
    • price_per_tib - BigQuery on-demand price per TiB (from your configuration or the default rate).
  • Capacity pricing (reservations)

    The cost is determined by how long each query runs on reserved compute. The usage shows the amount of that reserved compute time consumed by a query.

    Formula:

    compute_time_per_query * price_per_slot_hour

    Where:

    • compute_time_per_query - Total slot time used by the query (in hours). dbt sources this value from information_schema.jobs.total_slot_ms. For more information, see the BigQuery documentation.
    • price_per_slot_hour - BigQuery capacity price per slot-hour (from your configuration or the default rate)
  • Cached queries Queries served from cache do not consume compute and are counted as $0.

 Databricks

Databricks does not directly attribute usage to individual queries. Instead, dbt estimates per-query cost by proportionally allocating Databricks Units (DBUs) based on how long each query ran during a billing period.

  • Queries that run longer receive a larger share of usage.
  • Usage is converted to dollars using your list price.

Formula:

usage_per_query * cost_per_dbu

Where:

  • usage_per_query - DBUs attributed to the query.
  • cost_per_dbu - Dollar cost per DBU for the relevant stock-keeping unit. For information about the pricing system table, see the Databricks documentation.

Databricks reports usage in billing windows. These windows are periods of time where a compute resource consumed a known number of DBUs. Queries have their own start and end times. For information about the billing usage system table, see the Databricks documentation.

To attribute usage to queries:

  1. dbt identifies which billing windows each query overlaps.
  2. dbt calculates how long the query ran during each window.
  3. dbt allocates DBUs proportionally based on the query’s share of total execution time on that compute resource during the same window.

Conceptually:

DBUs_in_window * (query_runtime / total_query_runtime_in_window)

dbt sums this across all overlapping windows to get usage_per_query.

 Amazon RedshiftPreview

Cost Insights supports both Amazon Redshift Serverless and provisioned cluster deployments. dbt detects your deployment type automatically when testing the connection.

note

On Redshift, dbt attributes query costs using the comments it automatically injects into each query. If another process removes or replaces these comments, dbt can't tie the query back to its model, and its cost won't be attributed. Make sure nothing in your Redshift environment removes or replaces dbt's query comments.

  • Redshift Serverless

    dbt estimates cost by identifying which Redshift Processing Unit (RPU) billing periods overlap with each query's execution time and attributing the proportional share of RPU-hours to the query.

    Formula:

    rpu_hours_per_query * rpu_price_per_hour

    Where:

    • rpu_hours_per_query - RPU-hours attributed to the query based on its proportional overlap with each billing period. dbt sources billing period data from SYS_SERVERLESS_USAGE. For more information, see the Amazon Redshift documentation.
    • rpu_price_per_hour - Your RPU price per hour (from your configured value in Cost Insights settings).
  • Redshift Provisioned

    dbt estimates cost based on how long each query ran and how many nodes your cluster has.

    Formula:

    elapsed_time_hours * node_count * node_price_per_hour

    Where:

    • elapsed_time_hours - Query execution time in hours. dbt sources this from SYS_QUERY_HISTORY.
    • node_count - Number of nodes in your cluster. dbt sources this from STV_SLICES.
    • node_price_per_hour - Your price per node per hour (from your configured value in Cost Insights settings).

Additional considerations:

  • Data retention: Redshift system tables (SYS_QUERY_HISTORY, SYS_SERVERLESS_USAGE) retain only seven days of history. Cost data for Redshift may cover a shorter window than other warehouses. dbt calculates costs for whatever data is available within that window.
  • Pricing required: There are no default price values for Redshift. Costs will appear as $0 until you configure rpu_price_per_hour (serverless) or node_price_per_hour (provisioned) in Cost Insights settings.
Concurrent query costs

Redshift attributes cost to each query as if it ran alone on the cluster. If queries run concurrently, the sum of individual query costs may exceed your actual bill.

Cost reduction calculation

dbt calculates cost reductions by comparing actual costs to what costs would have been without model reuse. To do this, dbt uses data from the last seven days (where available) and performs the following steps:

  1. Calculates the average cost per model build.
  2. Counts how many times a model was reused instead of rebuilt.
  3. Multiplies the reused model count by the average cost per build to determine total cost reduction.

Formula:

average_cost_per_build * reuse_count

dbt calculates reductions per model and per deployment environment (production and staging), based on recent historical runs.

Additional notes:

  • dbt calculates estimated costs and savings daily.
  • Pricing inputs come from warehouse system tables (where available), connection-level configuration, or default list prices.

Example

The following example shows how dbt calculates cost reductions. Looking back seven days, assuming a model runs on two distinct days:

DayTotal costTotal executions
Day 1$55
Day 2$1010
Total$1515
Loading table...

The average cost per execution: $15 ÷ 15 runs = $1 per run

If the model was reused eight times instead of rebuilt during this same period, the estimated cost reduction is: $1 average cost per run * 8 reuses = $8

Considerations

Keep the following in mind when using Cost Insights:

Data collection and refresh

  • Cost Insights uses your platform metadata credentials to access warehouse system tables. No separate credentials are needed beyond the platform metadata setup.
    • You need sufficient permissions to query warehouse metadata tables.
  • Cost data is calculated once per day by a scheduled job that runs at approximately 17:00 UTC.
  • The data collection job processes completed calendar days only. It does not include the current day because warehouse usage data may still be incomplete.
    • Jobs that ran yesterday (or earlier) will have cost data available after the next daily refresh.
    • Jobs that ran today will not have cost data until the following day’s refresh, regardless of what time they ran.
  • If you don’t see cost data for a recent job, make sure at least one full calendar day has passed since it ran. The Updated badge in the Cost Insights section shows when the last refresh occurred.

Cost accuracy

  • dbt calculates costs using warehouse-reported usage data and applies default credit or compute costs based on standard warehouse pricing.
  • If you have custom pricing agreements with your warehouse provider, override the default values in your account settings to ensure accurate cost reporting. For more information, see Set up Cost Insights.
  • Update your cost variables whenever your warehouse pricing contracts change to maintain accurate tracking.
  • Changes to cost variables only apply to future calculations — historical cost data remains unchanged.

Optimization data

  • Optimization and usage reduction data is available once dbt State or state-aware orchestration is enabled and begins reusing models across runs.
  • For accounts already using dbt State or state-aware orchestration, run at least one full model build within the last 10 days before enabling Cost Insights to establish a baseline for cost reduction calculations. If you don't see cost reduction data, run a full build to establish the baseline.
  • Cost Insights currently calculates estimated reductions in warehouse compute usage at the model level and will expand to include tests and seeds in the future.

Exporting data

  • You can export cost data as a CSV file for further analysis and reporting. For more information, see Explore cost data.
Why might my actual warehouse costs differ from displayed costs?
How often is cost data refreshed?
How do I troubleshoot if cost data isn't appearing?
Does the Cost Insights feature incur warehouse costs?
How does increasing job frequency affect cost reduction estimates?
